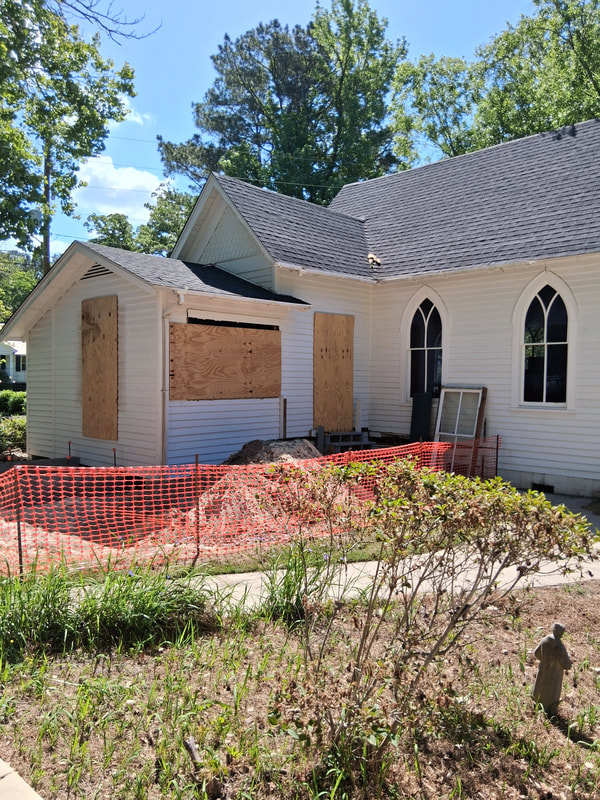

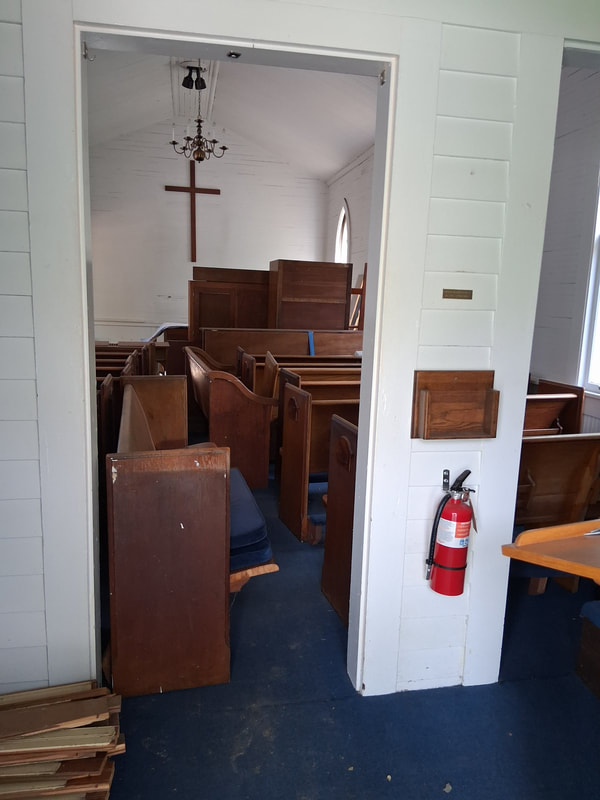

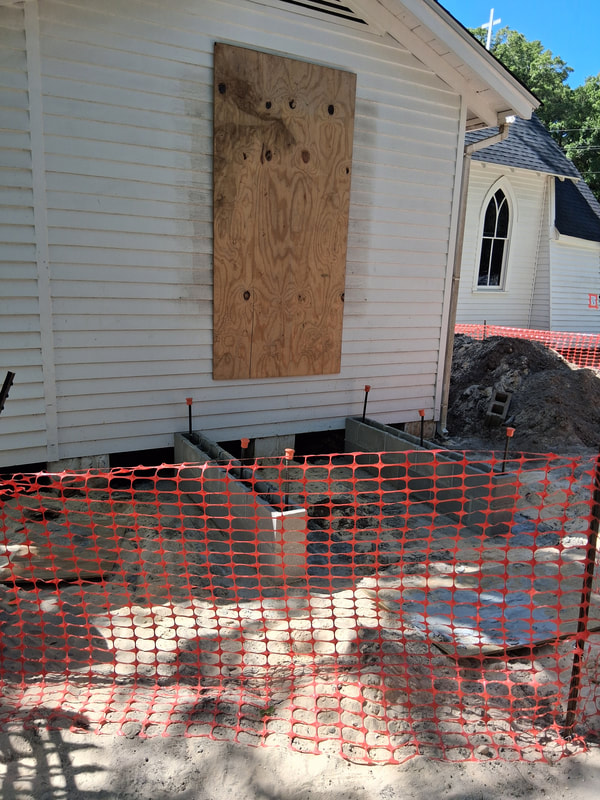

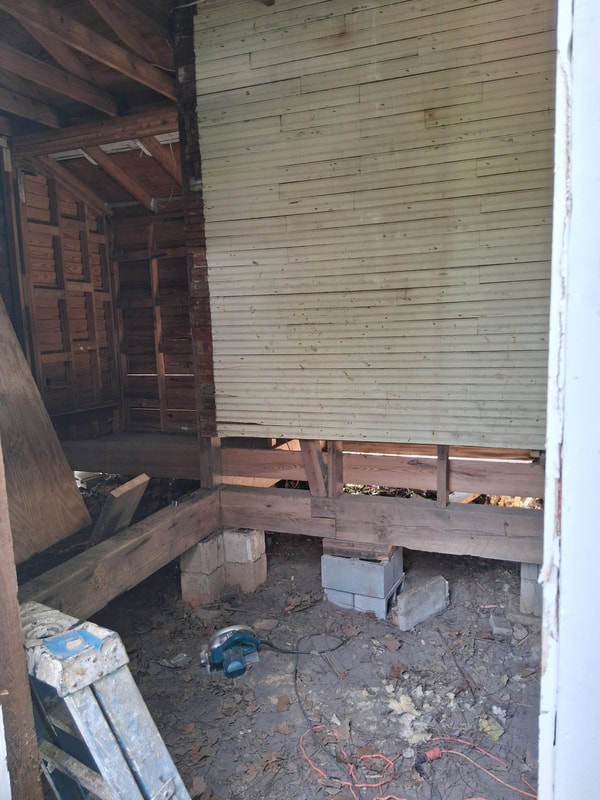

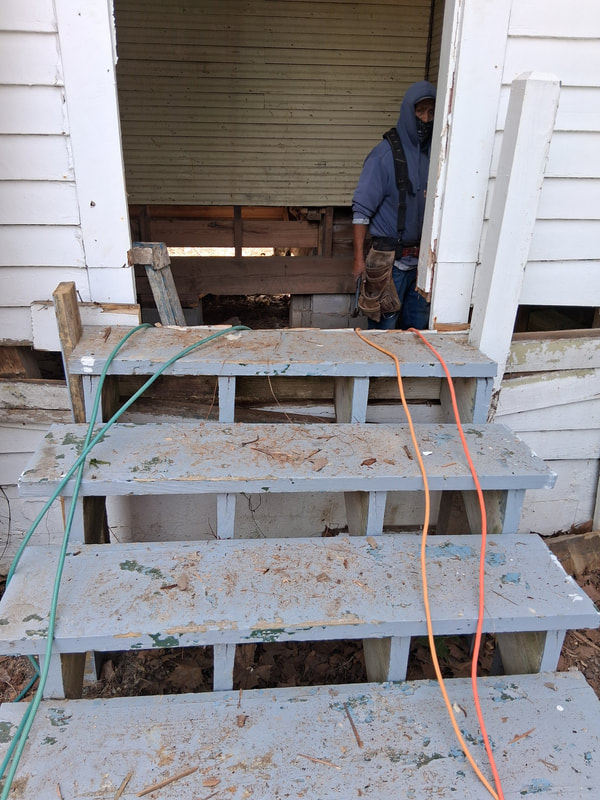

April 12: As of lunchtime Thursday, they have done the following: (1) removed the cabinets and bathroom fixtures; (2) removed the walls, floor, and ceiling in the sacristy and bathroom; (3) removed the two exterior a/c units and replaced the office a/c with one of those units; (4) removed all the ductwork from underneath the chapel; (5) removed the exterior door and porch from the sacristy; (6) removed the three windows from the sacristy and bathroom; (7) removed all the light fixtures; (8) dug the footings and placed the rebar for the foundations for the new extension and porch. If you have any questions, see Fr. Gary. FOR YOUR SAFETY: do not
|
April 20, 2026April 23, 2026April 29, 2026May 11, 2026May 14, 2026May 19, 2026May 28, 2026June 8, 2026 |
|

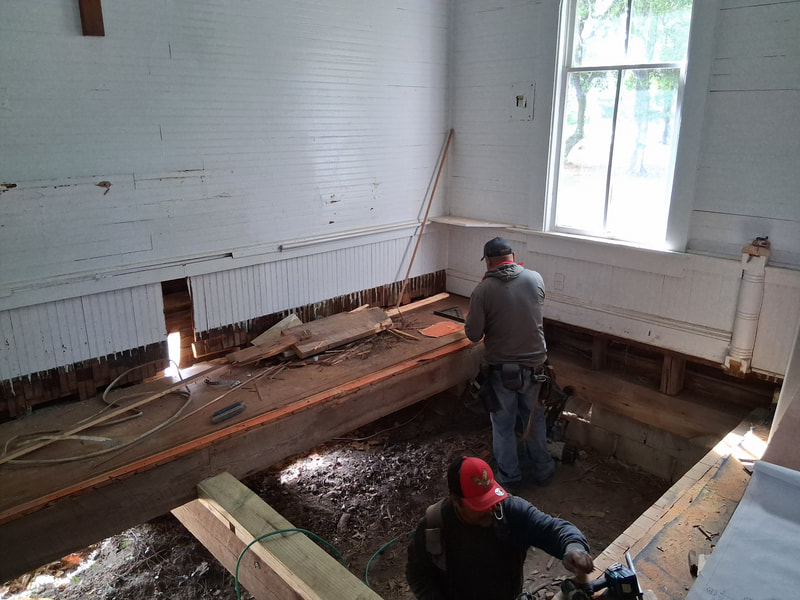

June 11: Last Friday they removed the carpet from the nave and narthex. The hardwood planks in the nave are in very good shape. Therefore, we will sand off the glue, stain, and varnish it. The floor in the narthex had to be demolished completely because it had been built upon the old porch, which would have cause sagging and moisture problems in the future. The new joists and subfloor have been completed. This will allow us to put in hardwood planks in the narthex and new chancel to match the planks in the nave. The front porch had to be demolished because it was sagging. Turns out, when it was constructed, it was not attached to the chapel. The new

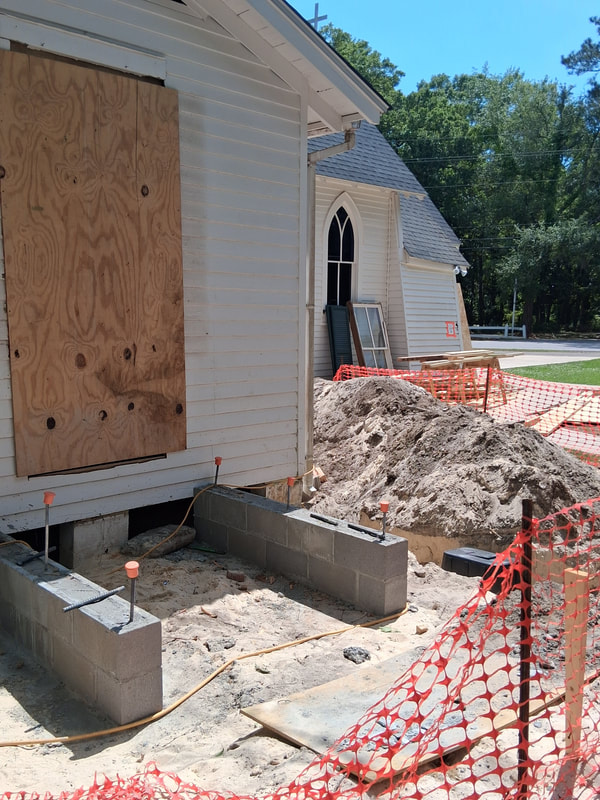

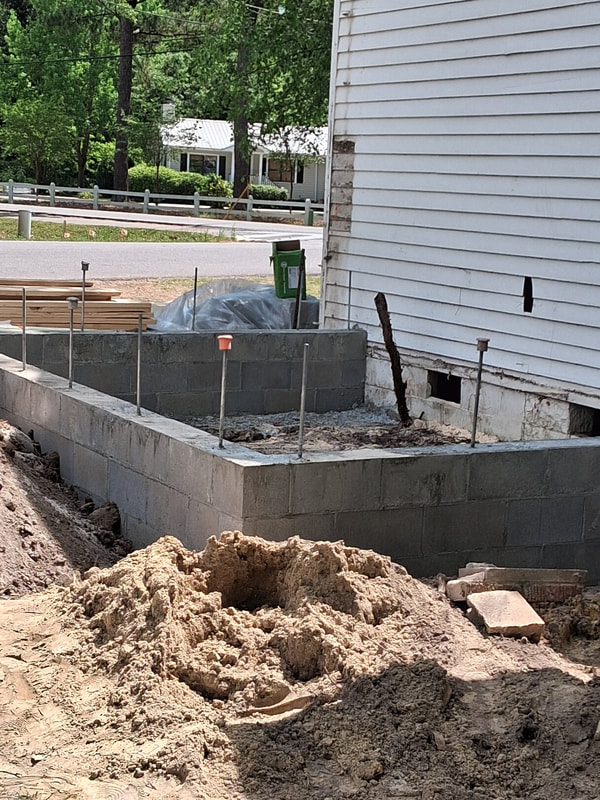

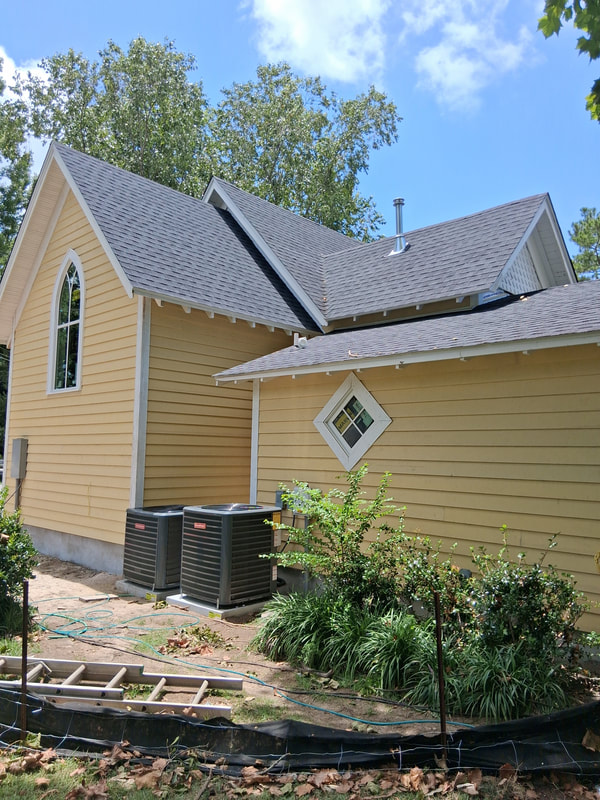

porch will be constructed properly and will last much longer. The electrical inspection was completed and we passed. The plumbing and HVAC inspections are scheduled for Monday. If those are completed, then next week they can install the insulation. The roofers installed all the flashing and shingles on the front porch, narthex, new side porch, and new chancel. The first order of new Hardie Board siding has arrived. Concrete footings around the entire chapel and footings and sidewalk for the exterior handicapped lift are being dug today (Thursday) and will be poured on Friday. |
|

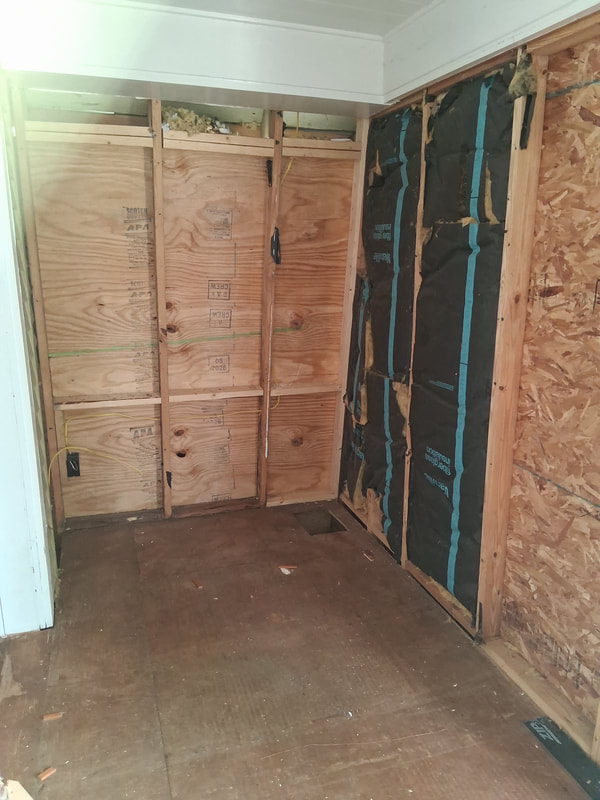

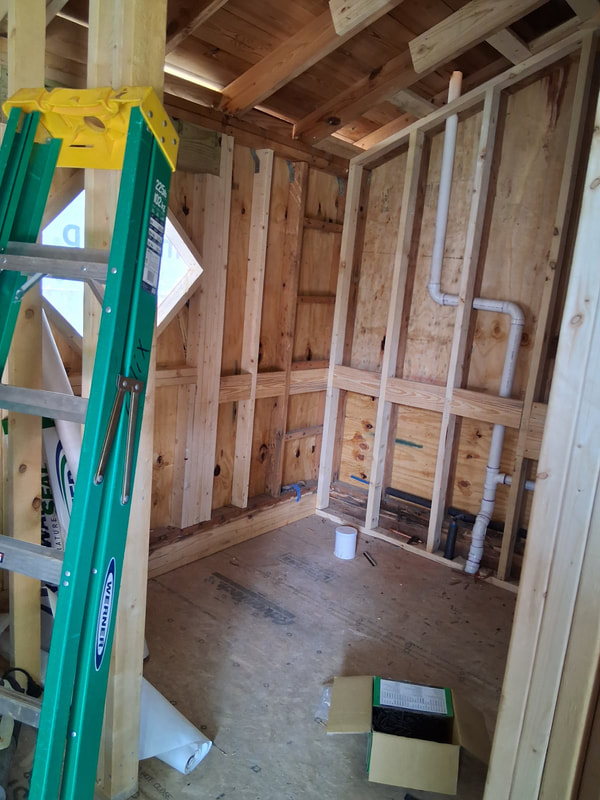

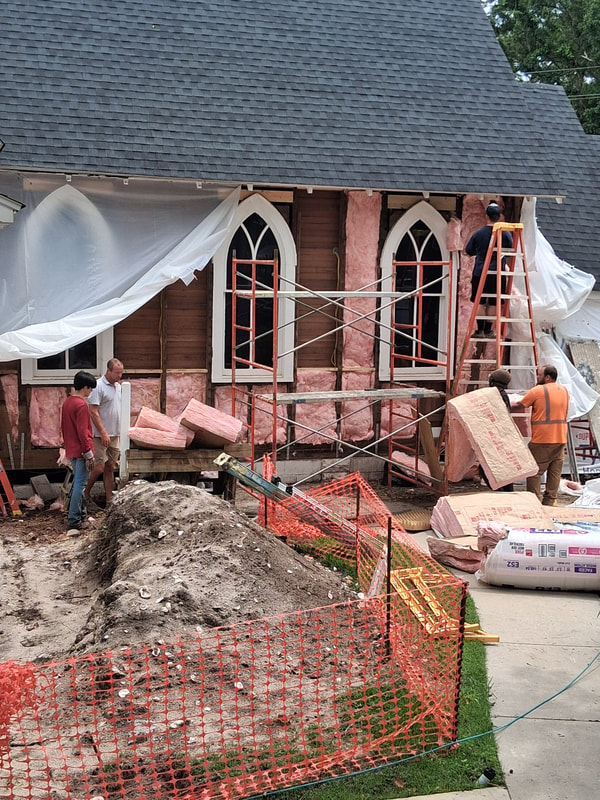

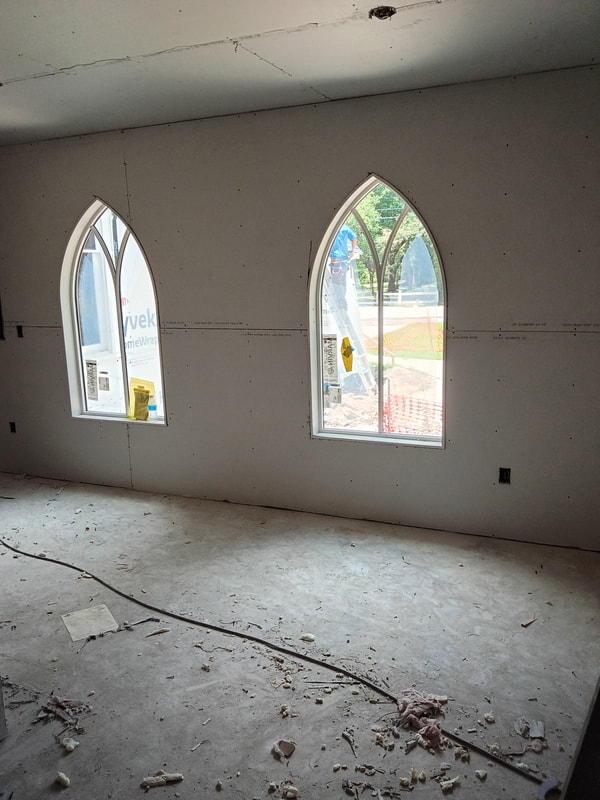

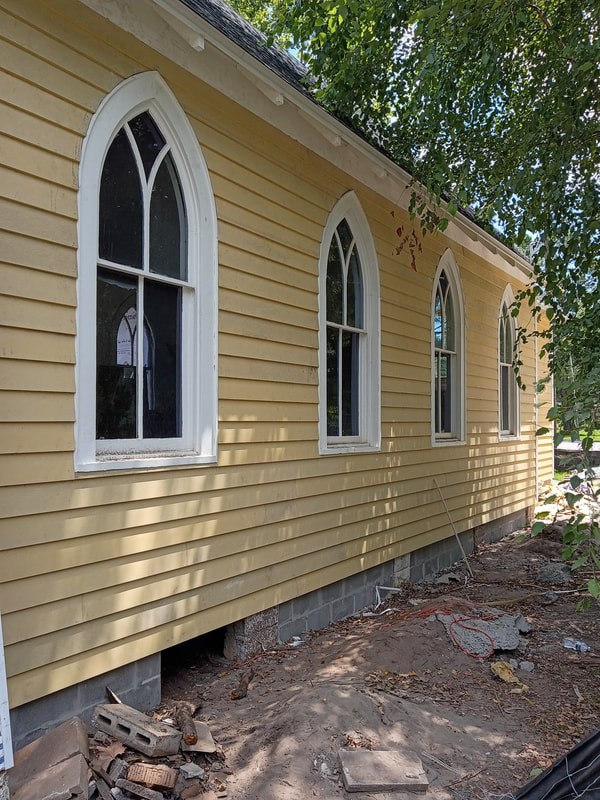

July 2: This report covers the last two weeks. The new footings were poured and the chapel crawl space was completely enclosed with concrete blocks. The insulation has been installed throughout the interior of the chapel. The drywall has been installed in the bathroom and sacristy. The new arched windows have been installed in the new chancel and in the front wall of the sacristy. The new window was installed in the bathroom. The Hardie-board lap siding has been installed on most of the new chancel, on the back of the bathroom/sacristy wall, and on the side facing Confederate Rest Road. Fr. Gary has ordered the new altar vestments: superfrontals, burses, and veils in all four liturgical colors: white, red, purple, and green.
|
|

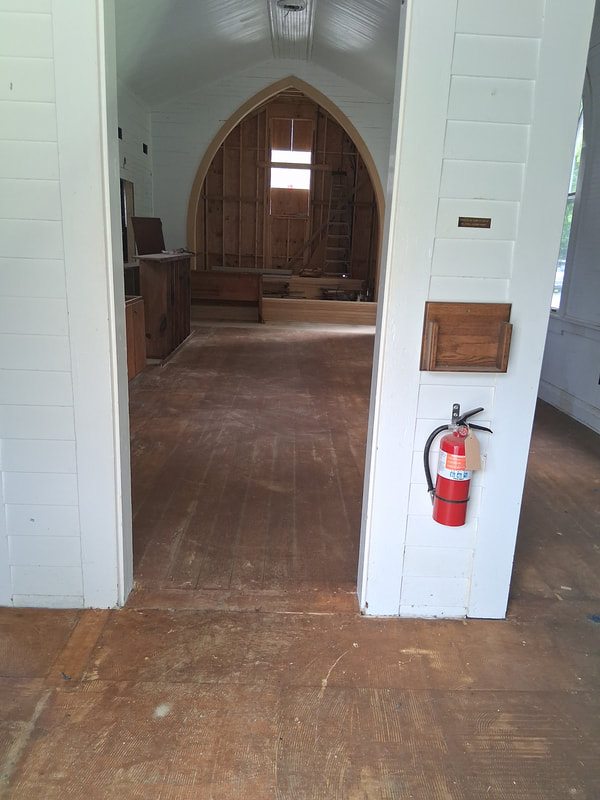

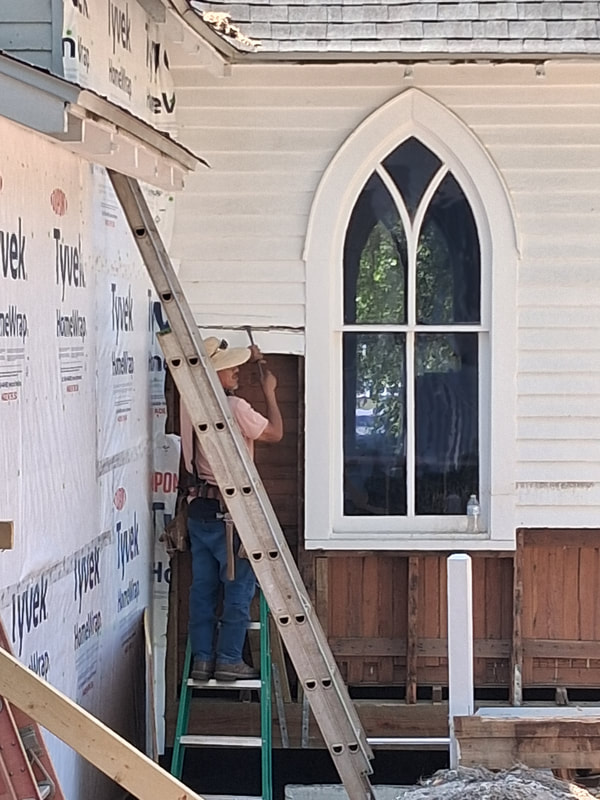

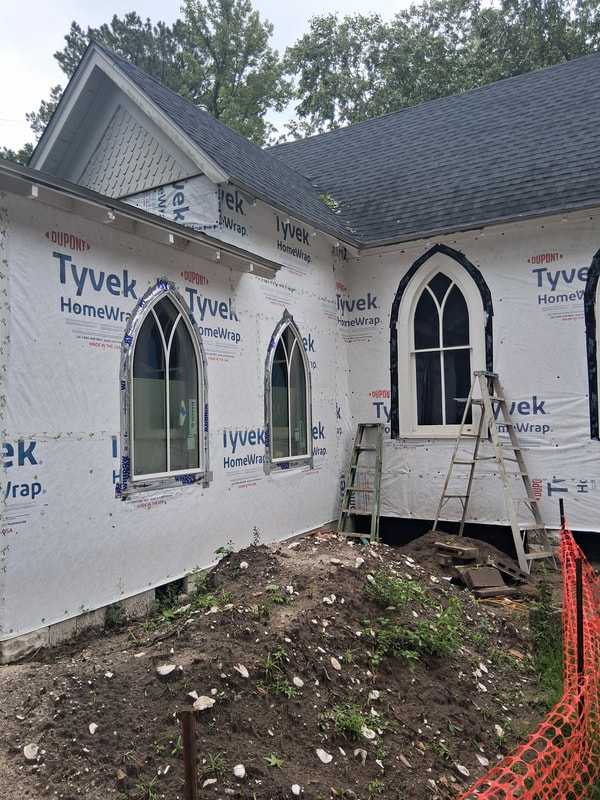

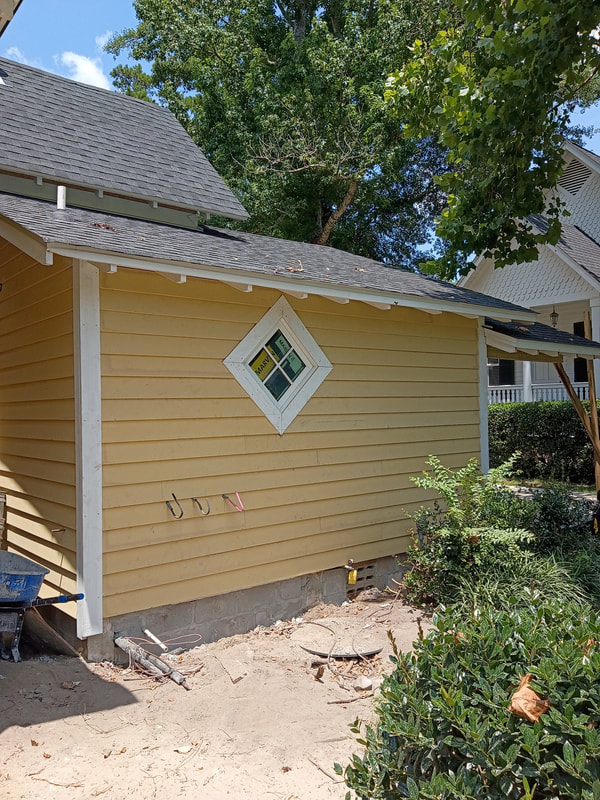

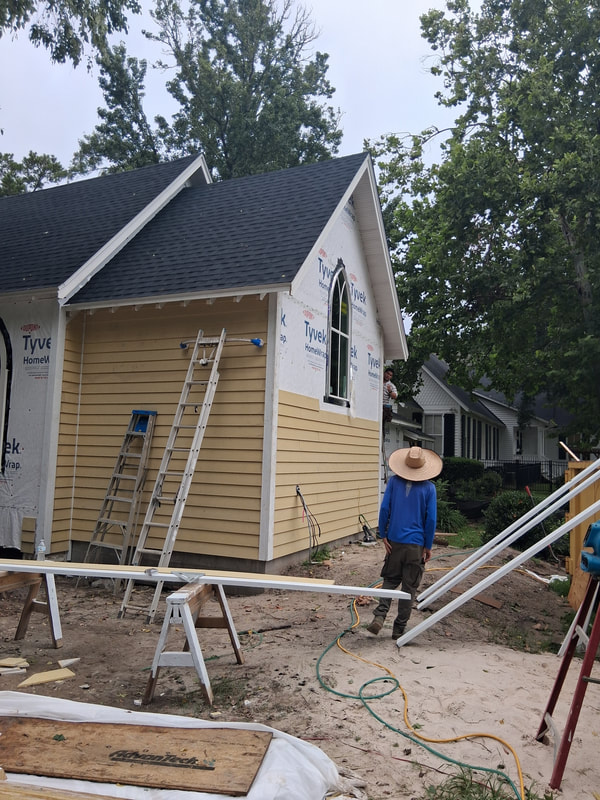

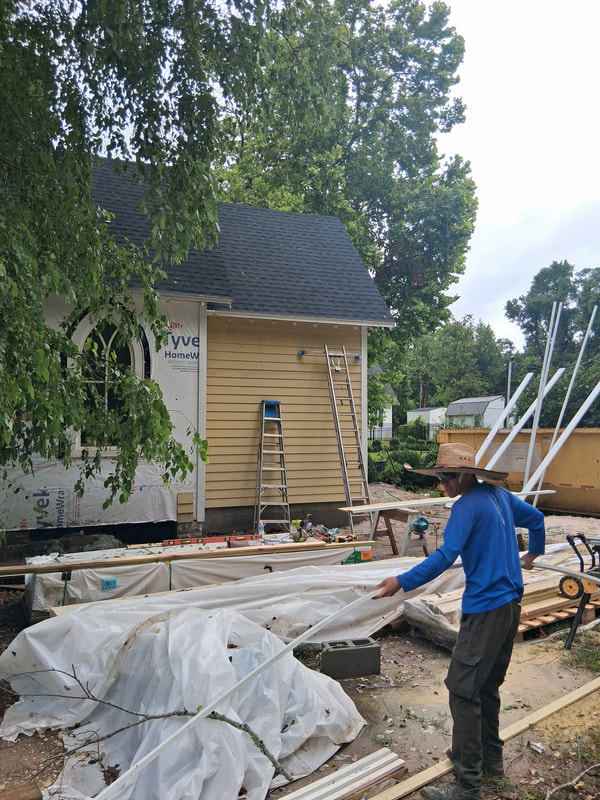

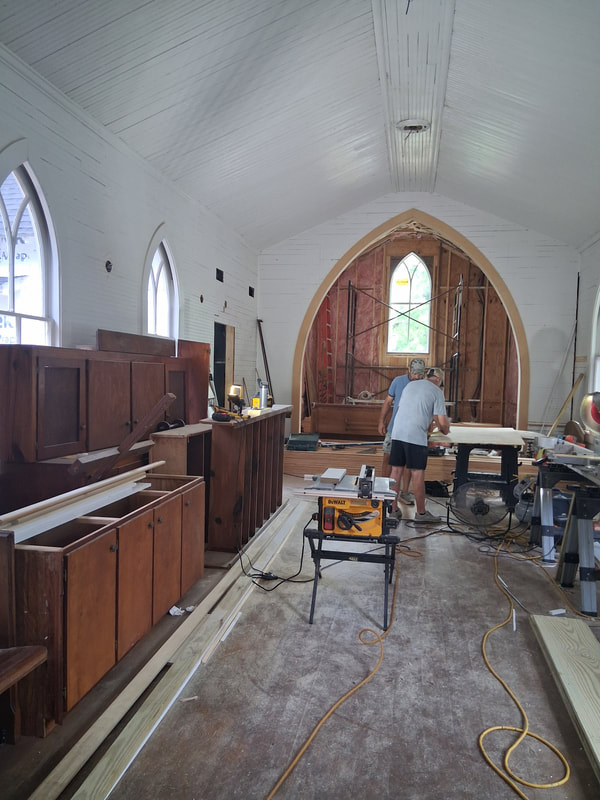

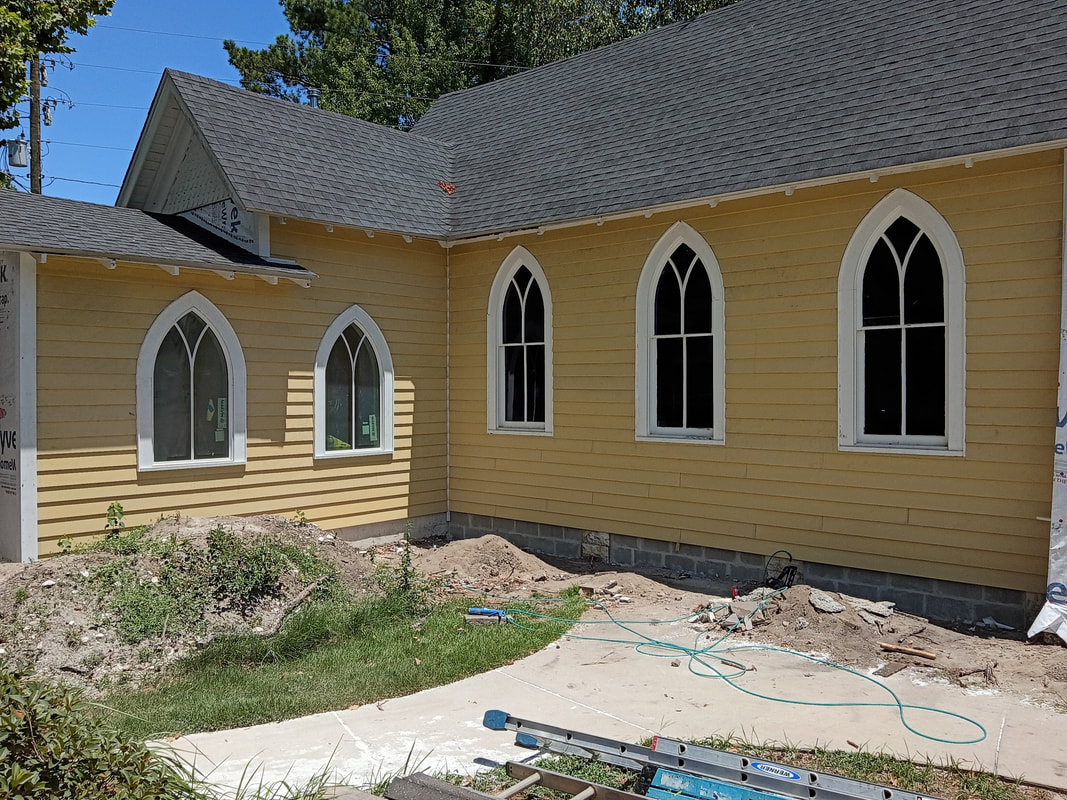

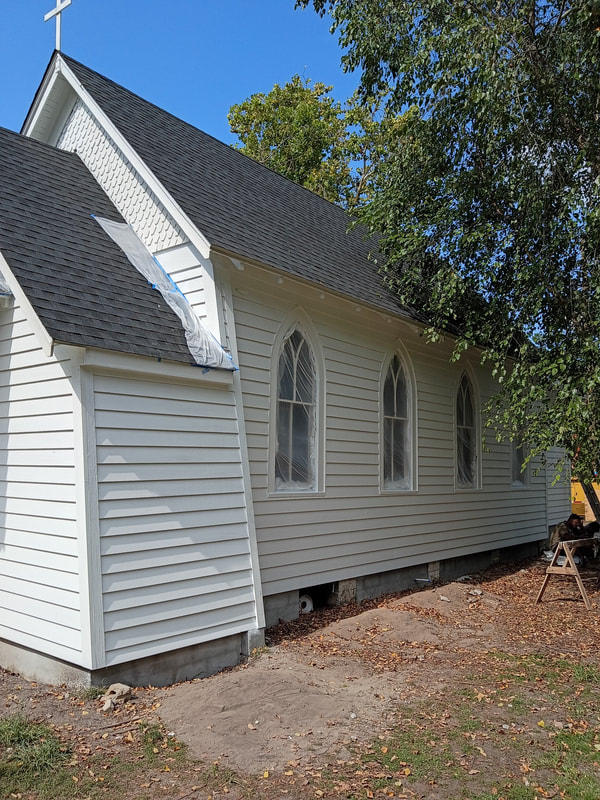

July 9: The trim was installed on the three gothic arched windows. Now they are installing the Hardie-board lap siding on the back wall of the chancel, the front wall of the sacristy and the side of the chapel facing the parish hall. The air conditioners have been reinstalled and temporary electric run to them. They will cool the chapel so the new wood can be conditioned before it is installed on the walls and the floor. We are retaining the existing beadboard in the main nave of the chapel. New beadboard will be installed in the new chancel and in the narthex. The new altar rail is being constructed. We are also retaining the wood floor we discovered under the old carpet. New, matching, wood flooring will be installed in the narthex and chancel. We have had several questions about the exterior color of the chapel. The Hardie-board comes primed in the yellow. The chapel will be painted white.
|
